The new Pakxan – Bueng Kan bridge

Moto-Rex

Moderator
Jan 5, 2008
944
287
63
The new Pakxan – Bueng Kan bridge.

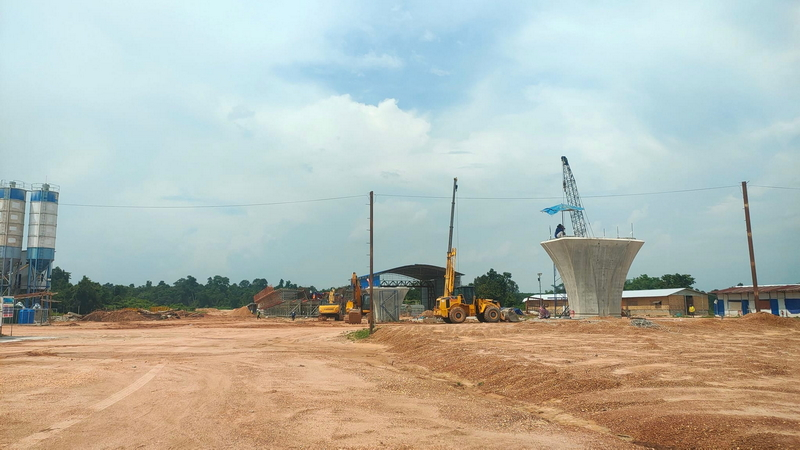

While crossing back into Thailand last week on the Pakxan ferry, I noticed that work had just begun on the new Laos-Thailand Bridge that will join the towns of Pakxan and Bueng Kan.

The bridge will be located just 100 metres from the where ferry landing and immigration offices on the Thai side currently stand.

The head officer said the bridge will be completed in 3 years,.. so look out for the opening on December 2016.

The Thai side,…and the large tree to the right of the excavator came down about 2 minutes after I took this photo.

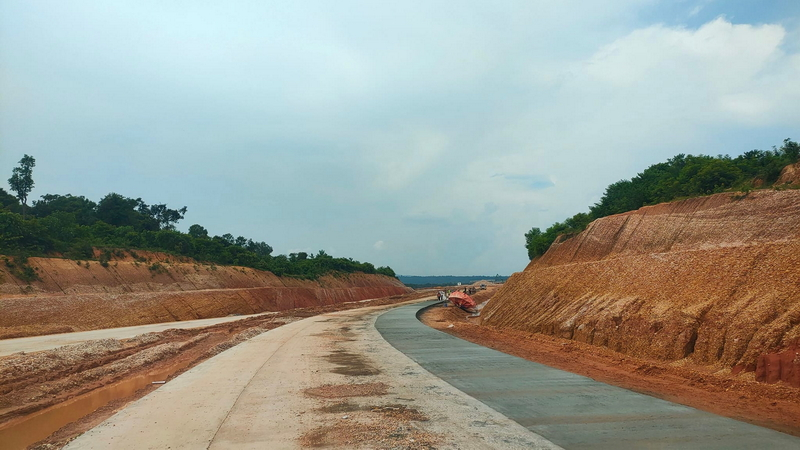

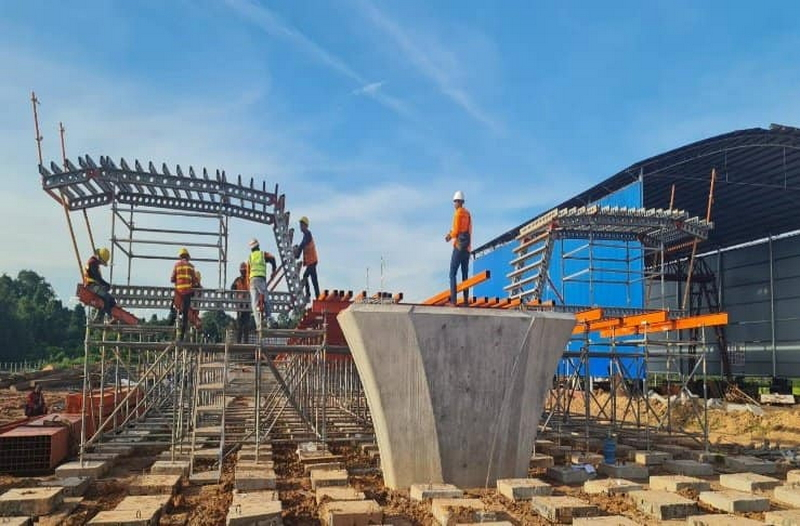

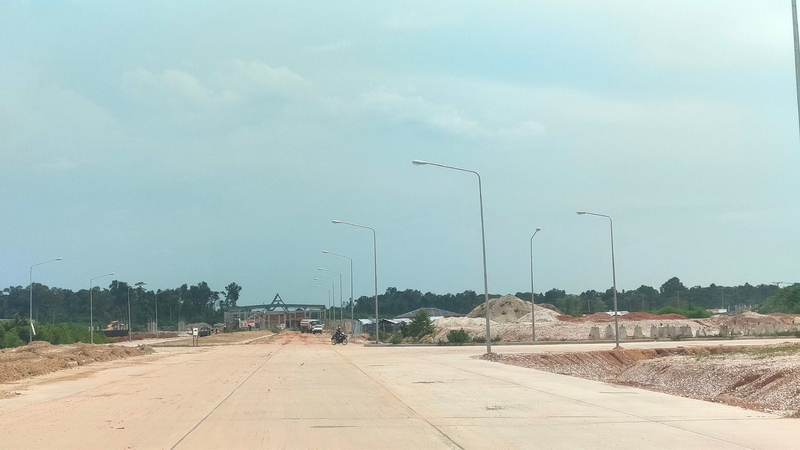

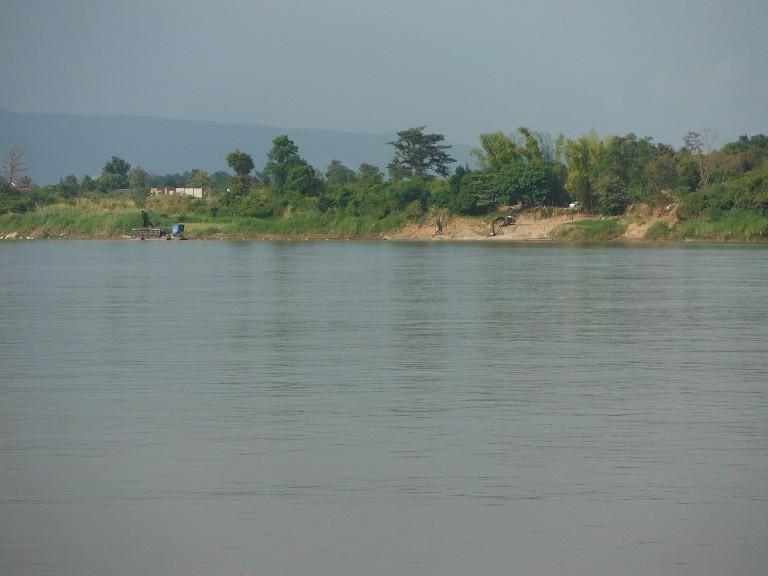

Work is also under way on the Lao side.




This is where the completed bridge will cross the river.


The KLX, on the spot that will be the very start of the bridge on the Thai side.



Moto-Rex


blkphantom

Ol'Timer
Feb 12, 2007
61
5
8
Rex, Can you tell us anything/everything about crossing now from Pakxan to Bueng Kan ?
I would like to return to Thailand from Lao at this crossing. Vientiane can be very busy and I would like to try a new crossing.
Thanks, Al


Moto-Rex

Moderator
Jan 5, 2008
944
287
63
blkphantom;295401 wrote: Rex, Can you tell us anything/everything about crossing now from Pakxan to Bueng Kan ?
I would like to return to Thailand from Lao at this crossing. Vientiane can be very busy and I would like to try a new crossing.
Thanks, Al
The Pakxan-Bueng Kan is one of the easiest places to cross. Just go to the ferry landing in Pakxan which is where customs and immigration are located, do the paper work, then get on the ferry which takes about 30 minutes to get to Thailand for 150baht. Once there do the paper work etc, and away you go.
On both sides the immigration and customs people are friendly and helpful.
Just remember Lao lunch break is between 11.30am and 1.00pm, and nothing happens then.
How long you have to wait for the ferry, is luck of the draw.

Hope this helps.


101Pauly

Member
Nov 21, 2012
10
0
0
Hello Rex:

Hope you are still having a great ride. Saw you in 101 before we headed down to Ko Chang... I believe you were off to Ubol/Pakse and beyond... happy new years!


DavidFL

Administrator
Staff member
Jan 16, 2003
12,533
2,964
113
67
Chiang Khong
www.thegtrider.com

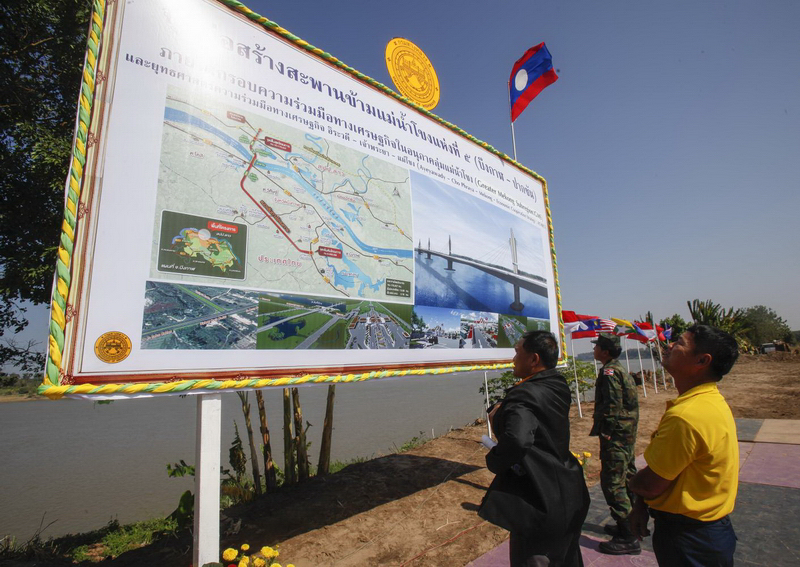

5th Friendship Bridge in pipeline

February 16, 2016 by Wanwisa Ngamsangchaikit

BOLIKHAMSAI, 16 February 2016: The construction of the 5th Lao-Thai Mekong Friendship Bridge, which will connect Bolikhamsai province in Lao PDR to Thailand’s Bung Kan province, should begin in 2019.

Lao News Agency quoted Department of Public Works and Transport’s Road Management Division head, Vixay Phoumy, saying the survey and design of the bridge is now 90% complete and the location for its construction has been finalised.

The final design of 5th Lao-Thai Mekong Friendship Bridge Construction Project has already been submitted to the governments of Laos and Thailand.

inside no 3“Currently, we are only waiting for the construction budget to be approved and the construction companies to make their final bids. Construction could begin in 2019 at an estimated cost of USD85 million,” the director said.

The two governments will share the cost of the bridge 50%-50%, he added.

The bridge will span the Mekong River approximately 1,350 metres long and 17 metres wide.

Once completed, the bridge will improve transport between two countries and should help to improve the local economies on both sides of the river. This bridge will link highway 13 in central Laos to northeast Thailand.

Currently, there are four Thai-Lao Friendship Bridges: Vientiane-Nong Khai; Savannakhet-Mukdahan; Khammouan-Nakhon Phanom; and Chaing Rai’s Chiang Khong-Bokeo’s Huay Xai.

Source: http://www.ttrweekly.com/site/2016/02/5th-friendship-bridge-in-pipeline/


DavidFL

Administrator
Staff member
Jan 16, 2003
12,533
2,964
113
67
Chiang Khong
www.thegtrider.com
Update April 2018

Construction of the 5th Thai-Lao friendship bridge likely to begin this year-end



Construction of the 5th Thai-Lao friendship bridge linking the northeastern province of Bueng Kan with Laos’ western township of Pakxan in Bolikhamsai province is likely to commence this year-end with the Ministry of Transport expecting to seek budget from the government in October.

Land clearing for the construction of a road heading to the site of the 3.6-billion-baht bridge project in Bueng Kan province has already started with land along the road being expropriated and landowners compensated. Rubber trees along the route have also been felled for the road construction.

Bueng Kan governor Phisut Busayapanpong said that Bueng Kan has the logistic capacity to cater to the increased passenger and cargo traffic in Nong Khai and Nakhon Phanom once the two provinces are linked by dual track train system and high-speed train system with Bangkok.

He said the people of Bueng Kan had the expectation that the new friendship bridge linking the province with Pakxan in Laos would boost trade, investment and tourism in the province and help improve its economy.

The bridge will also facilitate the flow of goods and people from northeastern Thailand through Laos into Vietnam and southern China and vice versa.

The volume of border trade in Bueng Kan for the first six months of this fiscal year amounted to 4.7 billion baht with Thai exports accounting for 3 billion baht.

With the completion of the bridge, Bueng Kan Customs Office expects that border trade will multiply to about 30 billion baht per annum.

Source: Thai PBS News. 22 April 2018



DavidFL

Administrator
Staff member
Jan 16, 2003
12,533
2,964
113
67
Chiang Khong
www.thegtrider.com
Slower progress than announced maybe but it is moving ahead.

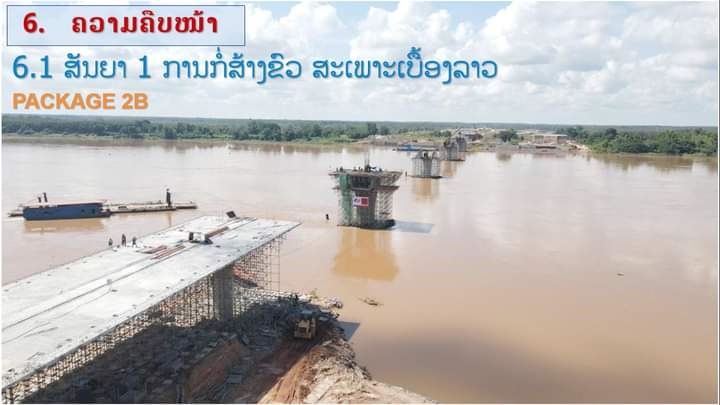

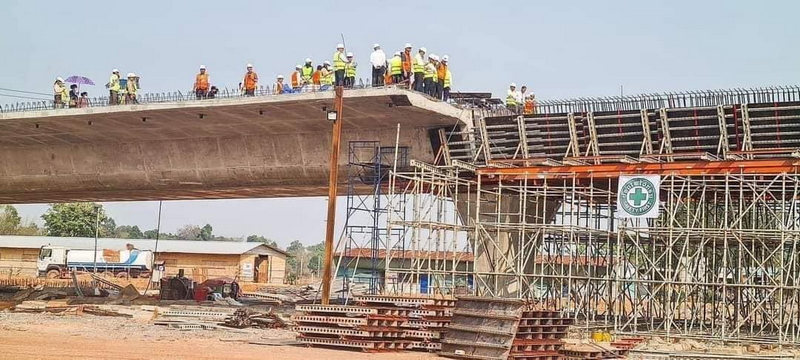

Update 20 June 2019 - The Bangkok Post

The total budget for the co-investment project will be 3.9 billion baht. The Thai government will invest 2.6 billion baht while the Lao government will invest another 1.3 billion baht that it will loan from the Neighbouring Countries Economic Development Cooperation Agency founded in 2005 by the Thai government.​



The project will consist of a 15km four-lane road, starting from Muang district of Bueng Kan to Paksan town of Bolikhamxay. The bridge over the Mekong River will be 1.3km long and will be a two-lane concrete bridge.

The budget also includes border checkpoints and border control facilities in the two countries.

The 36-month project is scheduled to complete in 2022.​

Source: New Friendship Bridge


DavidFL

Administrator
Staff member
Jan 16, 2003
12,533
2,964
113
67
Chiang Khong
www.thegtrider.com
Update January 2021 - a delay? 55 Just starting..

7 January 2021

Construction of 5th Lao-Thai bridge begins

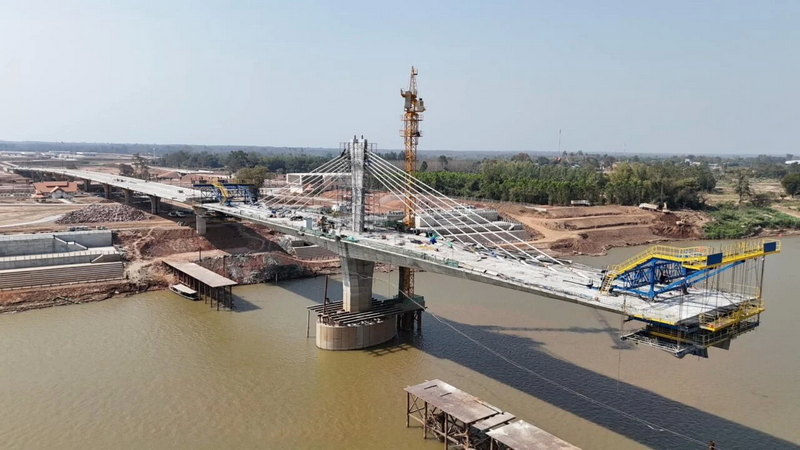

VIENTIANE (Xinhua) – Work on a fifth bridge linking Laos and Thailand across the Mekong River has begun after a construction agreement was signed in December.

The bridge, which will take 36 months to build, will connect Bolikhamxay province in Laos to Thailand’s northeastern province of Bueng Kan.

Local daily Vientiane Times yesterday quoted Project Director Laythong Phommavong as saying that work is currently focused on the site where the bridge and immigration facilities will be built.

We are clearing land on a 50-hectare area prior to starting construction and this work is now 80 percent complete,” he said.

The total cost of construction is estimated to be $130.3 million, of which Laos will be responsible for some $46.13 million.

When the bridge is completed in 2023, it will enable Bolikhamxay to become another regional trade hub and transit route for Laos, Thailand and Vietnam over a distance of just 150 kilometres, said the report.

Source: Construction of 5th Lao-Thai bridge begins - Khmer Times


DavidFL

Administrator
Staff member
Jan 16, 2003
12,533
2,964
113
67
Chiang Khong
www.thegtrider.com

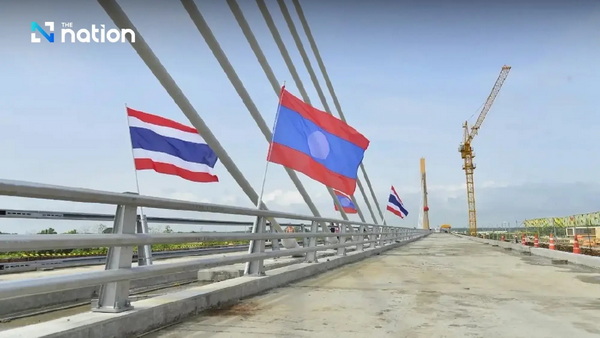

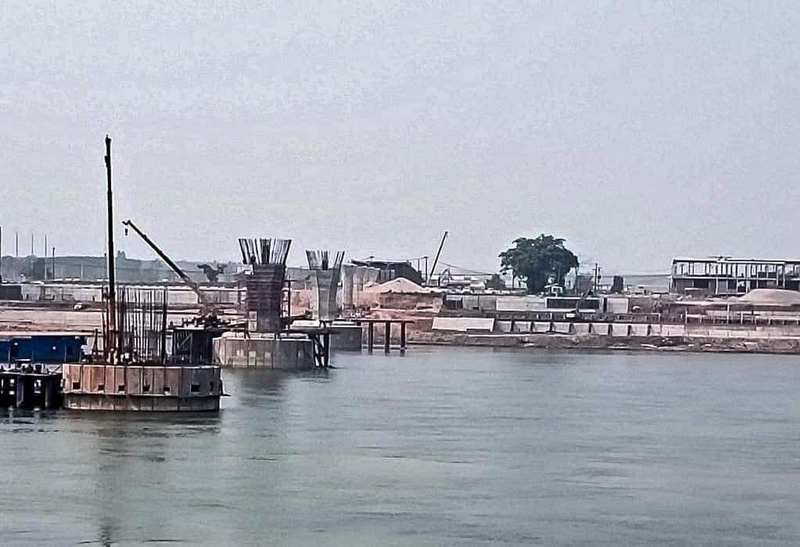

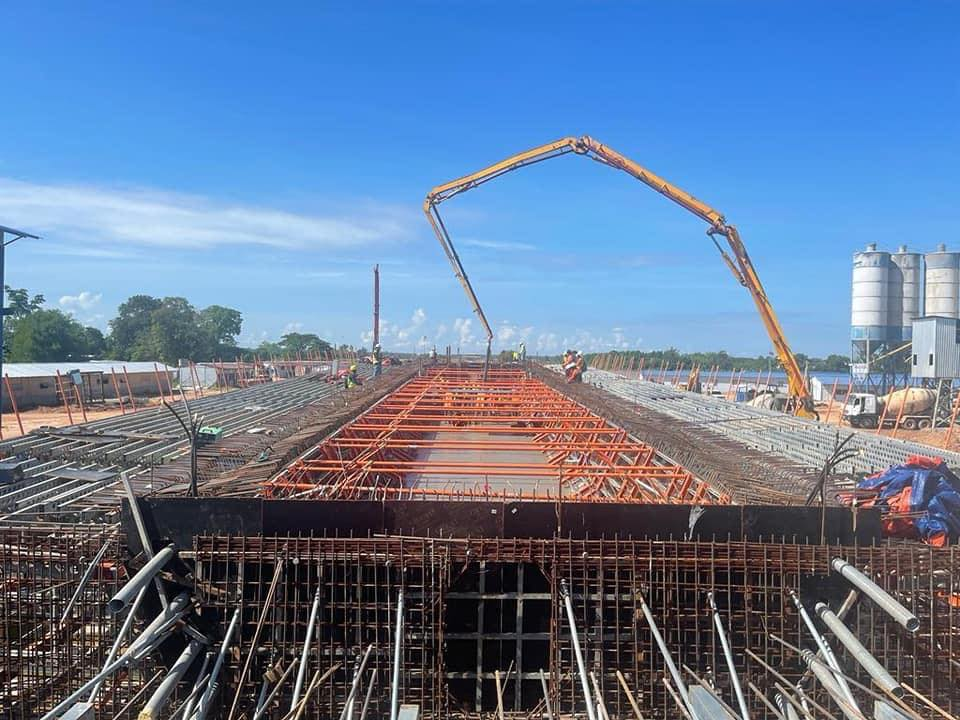

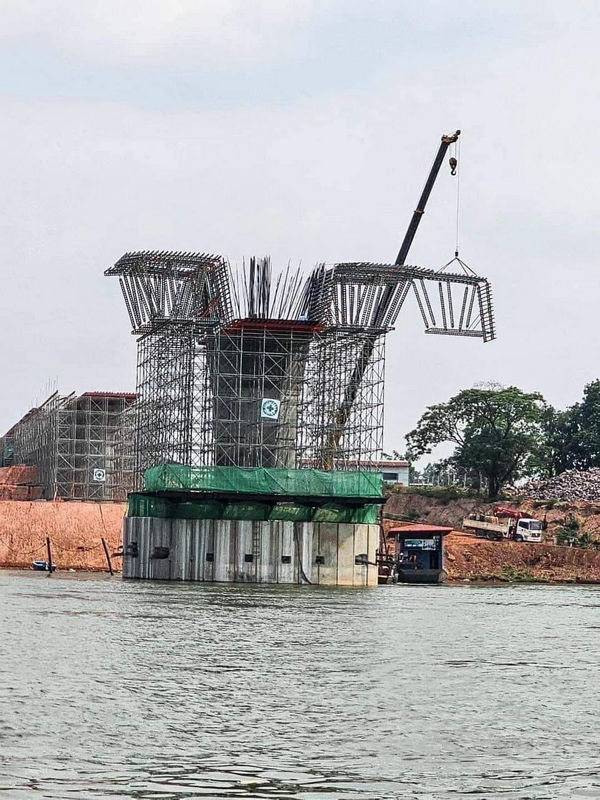

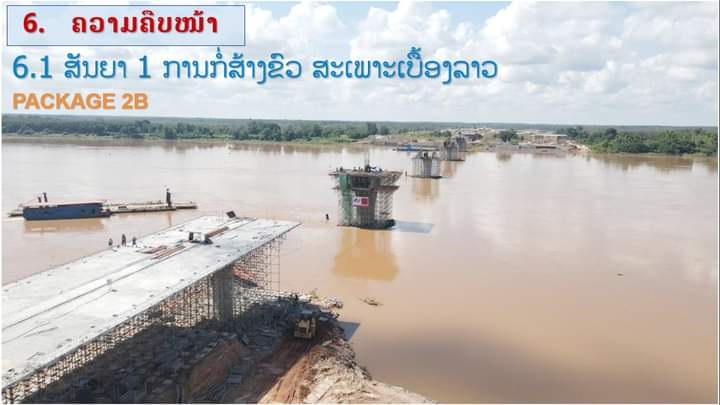

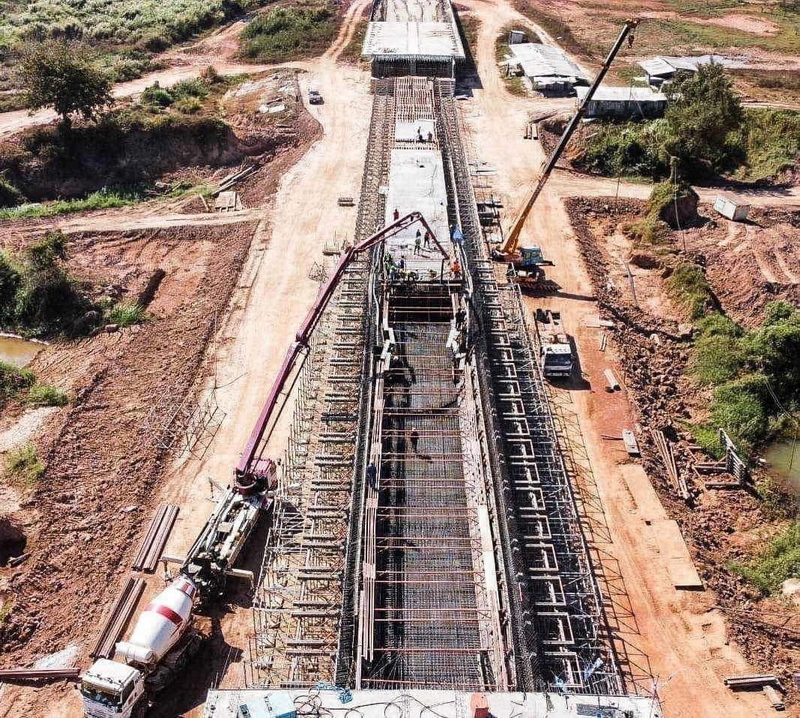

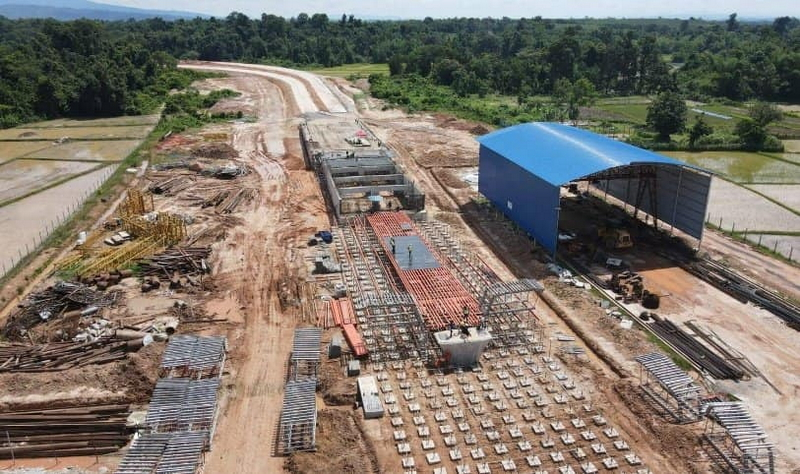

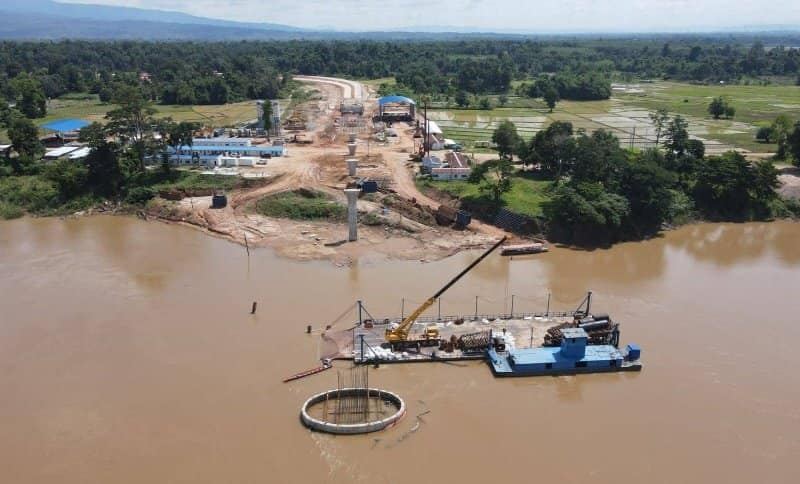

I passed by last week and they are still clearing land - no concrete poured yet. It will probably be 2024 before it opens with a 36 month construction period - hopefully the borders are open by then.
I passed by last week and they are still clearing land - no concrete poured yet. It will probably be 2024 before it opens with a 36 month construction period - hopefully the borders are open by then.

Funny how it goes. Moto Rex first checked this out in 2013 & the foreman said it would be ready in 2016...55
It is definitely a work in progress.
Thanks for the update.
Did you get any photos you can share?
